Network Infrastructure Upgrade

Introduction

A network infrastructure upgrade is a business continuity and growth decision. It determines whether your organization can scale, secure data, and keep operating when something goes wrong.

Most upgrade conversations start with a symptom: recurring outages, sluggish applications, a firewall nobody trusts anymore, or a new office that the current setup simply can't support. Add in cloud adoption, hybrid work, and rising security expectations, and "just add more bandwidth" stops being a real answer.

This guide walks through how to determine whether an upgrade is actually needed, assess your current environment, and choose a modernization path that fits your business—not just the newest product on the market. It also covers implementation planning and how to measure results without overspending or creating unnecessary disruption.

Key Takeaways

  • A network can run without visible failures yet still be unable to support growth, cloud workloads, or security requirements
  • Start with business requirements, asset visibility, and performance data before evaluating any technology
  • Prioritize fixes by business impact, security exposure, and end-of-support risk, not by device age alone
  • Use phased rollouts, testing, and rollback plans to limit operational risk during the upgrade

How to Assess Whether Your Network Infrastructure Needs an Upgrade

Not every network problem calls for the same fix. A routine technology refresh replaces aging hardware with equivalent gear. A targeted upgrade solves a specific bottleneck, like weak Wi-Fi in one building. Infrastructure modernization rethinks the architecture itself. The right scope depends on the problem you're solving, not the age of one switch or the existence of a shiny new product.

Operational Warning Signs

Start by listing what's actually happening day to day:

  • Recurring downtime or dropped connections during business hours
  • Inconsistent Wi-Fi coverage or slow application performance
  • Overloaded internet or WAN links during peak usage
  • Limited visibility into what's happening on the network
  • Manual troubleshooting that eats up IT time
  • Growing user or customer complaints about connectivity

These aren't just annoyances. ITIC's 2024 downtime survey found that an hour of IT downtime exceeded $300,000 for more than 90% of surveyed mid-size and large enterprises. That figure covers IT downtime broadly, not network outages specifically, but it puts the stakes in perspective.

Security and Lifecycle Red Flags

Aging equipment creates risk even when it hasn't failed yet. Watch for:

  • Unsupported firmware or end-of-life firewalls and switches
  • Replacement parts that are no longer available
  • Weak network segmentation or obsolete encryption
  • Expired warranties or support contracts
  • Inability to meet compliance or cyber-insurance requirements

CISA has flagged unsupported firewalls, routers, and VPN gateways as common targets for threat actors seeking network access. That guidance directly binds federal agencies, but the underlying risk applies to any business running past-end-of-support edge devices.

Business Change Can Force the Issue

Sometimes the network hasn't "failed" at all; the business has simply outgrown it. Common triggers include:

  • Opening, consolidating, or acquiring locations
  • Cloud migration and rising transaction volumes
  • Growth in video, voice, IoT, or remote-work traffic

When growth outpaces design, assessment matters as much as repair.

Build a Current-State Inventory

Before choosing anything, map what you actually have: routers, switches, firewalls, access points, circuits, cloud connections, critical applications, providers, contracts, and support status. Write down the unknowns instead of assuming the environment is fully understood.

Prioritize problems before technology. Rank each issue by:

  • Business criticality and security exposure
  • User impact and likelihood of failure
  • Effort required to fix

Separate symptoms from root causes—for example, whether slow applications come from insufficient bandwidth, poor wireless design, or security inspection overhead. Then set measurable objectives from your own baseline data, such as higher availability, lower latency, or stronger segmentation—not invented targets.

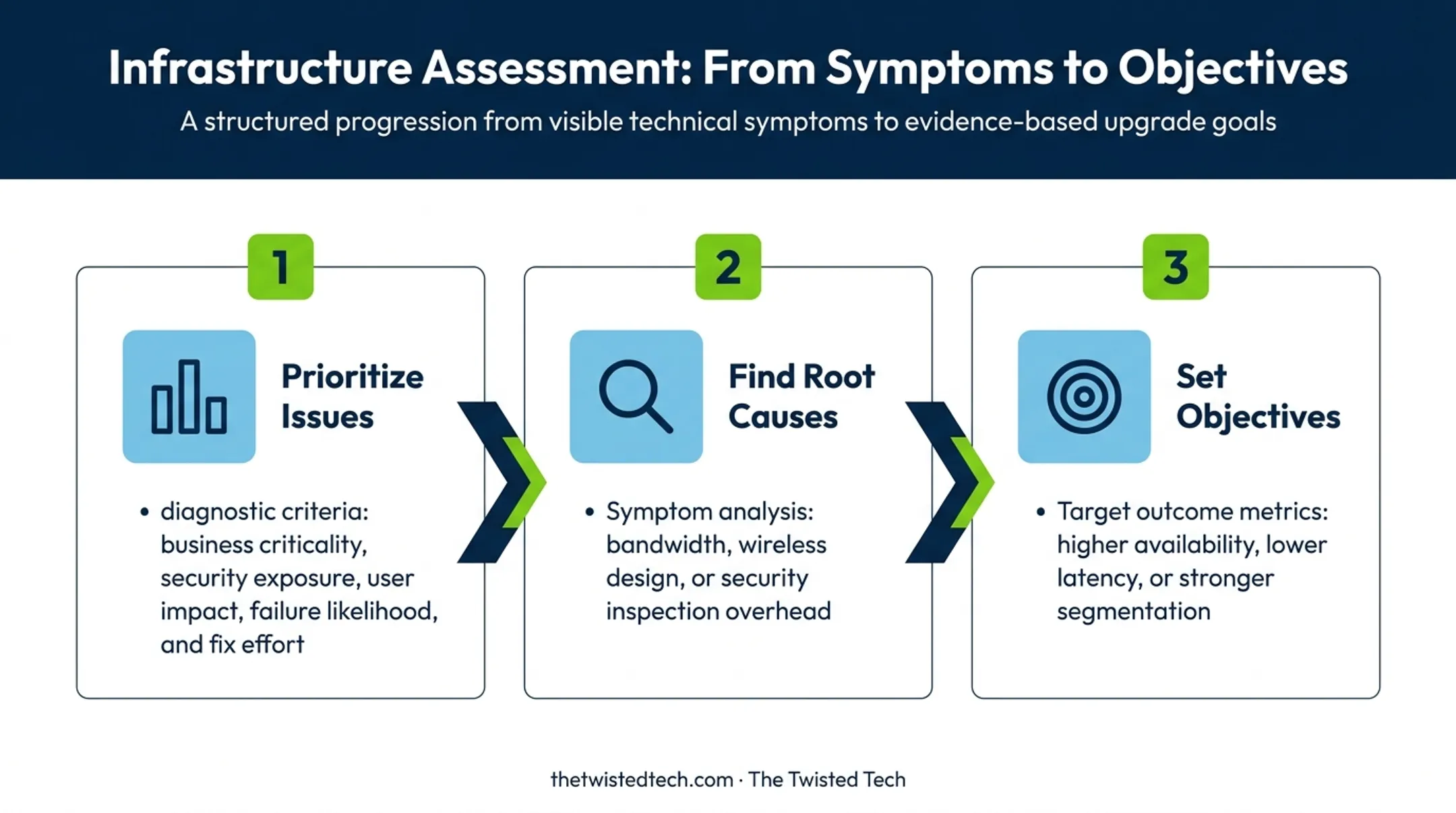

Three-stage network assessment from symptoms to measurable objectives

Network Upgrade Design and Technology Choices

Once priorities are clear, design decisions stack up quickly. Each choice should map to a documented business requirement—not a vendor pitch.

Typical design domains include:

  • Internet and WAN connectivity
  • SD-WAN or alternate routing
  • Switching and firewall architecture
  • Wireless coverage and network segmentation
  • Cloud connectivity, monitoring, and remote access
  • Redundancy and failover

Choosing an Upgrade Path

There's no single universal answer here. Common paths include:

  • Targeted replacement — swap end-of-life gear when the architecture still works
  • Architecture redesign — rethink segmentation, routing, or security models
  • Connectivity or carrier changes — fix bandwidth or reliability bottlenecks
  • Managed networking — cover gaps when internal network staff is limited
  • Cloud-connected infrastructure — support heavy SaaS or public-cloud workloads

Many organizations use a phased mix of these paths, sequenced by risk and business impact.

Resilience by Design

Redundant circuits, failover paths, high-availability security appliances, and backup power aren't optional for distributed businesses. NIST contingency-planning guidance recommends preparatory functional tests before a full, potentially disruptive failover test—a step teams often skip under deadline pressure and pay for later.

Build security into the design from the start:

  • Segment guest, corporate, voice, IoT, and operational traffic
  • Enforce least-privilege access
  • Use secure remote access
  • Centralize logging for visibility and response

Evaluating Emerging Options

Wi-Fi 6/7, SD-WAN, SASE, fiber, 5G or fixed wireless backup, and intent-based networking are often sold as must-haves. Useful options still fail when they don't match your environment.

Compatibility and cost details matter. Wi-Fi 6E needs 6 GHz-capable hardware, so many access points require replacement—not a firmware update. SD-WAN pricing usually shifts with bandwidth tier, management model, and contract term, so there is no single "cost of SD-WAN."

Score each option against:

  • Hardware and software compatibility
  • Licensing structure and contract terms
  • Internal skills and support model
  • Total cost of ownership, not feature sheets alone

Choose the design that satisfies documented requirements at a sustainable cost—not the one with the loudest launch narrative.

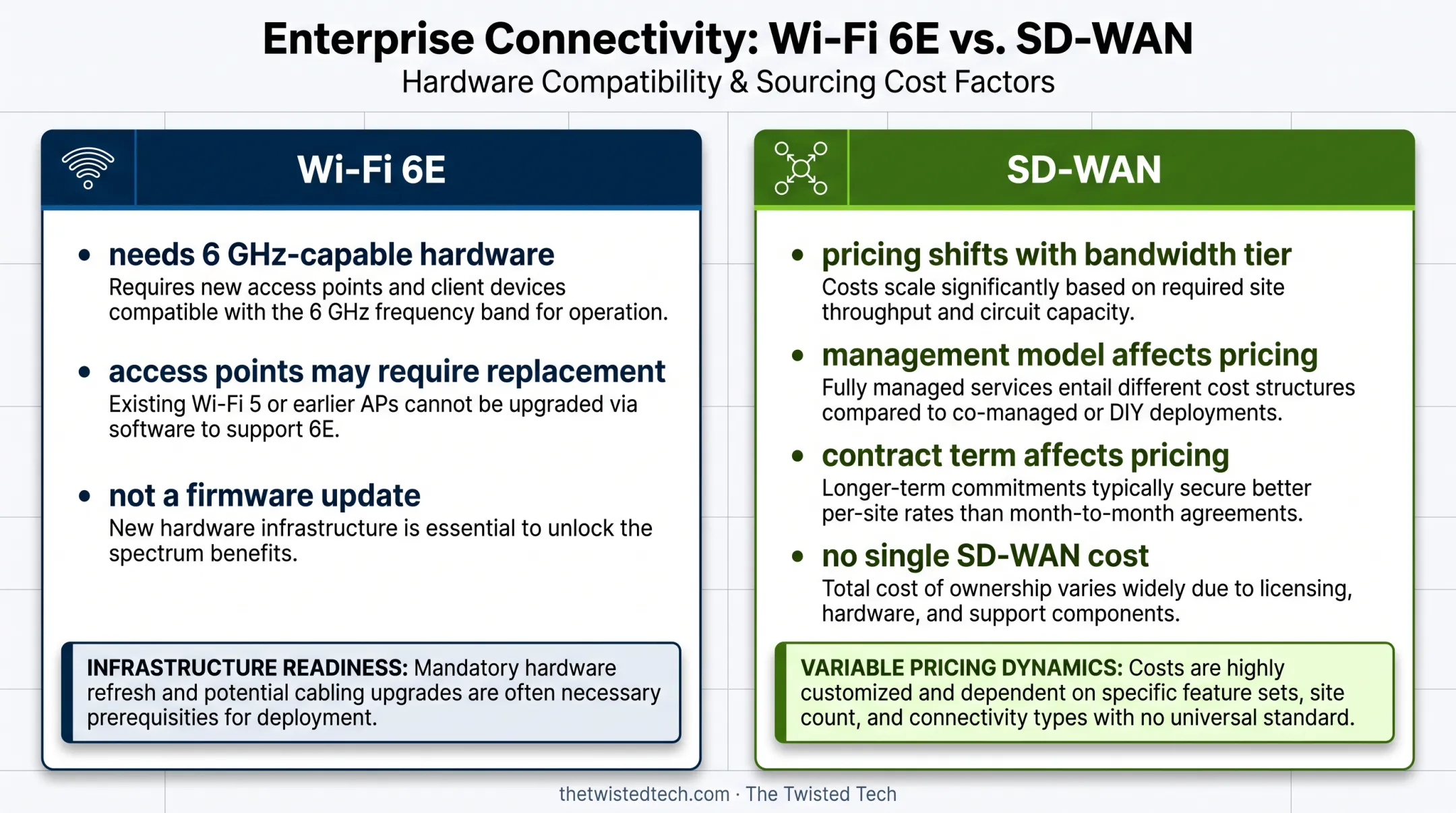

Wi-Fi 6E and SD-WAN compatibility and cost considerations comparison

Build a Business Case and Select Providers

An upgrade proposal is only as good as the total cost of ownership behind it. Look past hardware sticker price and account for:

  • Equipment, licensing, and connectivity
  • Installation, support, monitoring, and training
  • Migration, maintenance, and power
  • Downtime risk and future expansion

Create a Vendor-Neutral Requirements Document

Build this before you talk to a single provider. Include:

  • Technical fit against your documented requirements
  • Support model and service-level commitments
  • Security capabilities and compliance alignment
  • Implementation responsibilities and timelines
  • Contract flexibility, renewal terms, and exit provisions
  • Interoperability with existing systems

Compare Proposals Consistently

Map each proposal back to your requirements list. Identify assumptions and exclusions. Separate one-time costs from recurring ones. Validate references and case studies rather than taking a sales deck at face value.

This is where many organizations get stuck. Comparing three providers' proposals—each structured differently and emphasizing different strengths—takes time and expertise internal teams often lack.

The Twisted Tech works with growing, multi-location organizations through this stage. As an independent, vendor-neutral advisory firm, it helps clients assess their current environment and evaluate technologies and providers across business internet, SD-WAN, managed networking, Wi-Fi, and firewalls.

The Connectivity, Network & Infrastructure Advisory service covers side-by-side proposal comparison, commercial negotiation support, and an upgrade roadmap that does not lean on a single vendor's recommendation. Work starts with business requirements, locations, users, and growth plans before any technology gets evaluated.

How to Plan and Implement the Network Infrastructure Upgrade

Implementation works best as a sequence, not a single event:

  1. Discovery and baseline measurement — document current performance before anything changes
  2. Requirements approval — get sign-off on what the upgrade must achieve
  3. Target-state design — finalize the architecture and technology choices
  4. Procurement — order equipment and confirm circuit or carrier timelines
  5. Lab or pilot testing — validate configurations before touching production
  6. Stakeholder communication — notify affected teams and set expectations
  7. Site readiness checks — confirm power, cabling, and space at each location
  8. Production cutover — execute the change during an approved window
  9. Validation — confirm the new environment meets objectives
  10. Transition to ongoing operations — hand off documentation and support

Build a Detailed Cutover Plan

Before production cutover, lock the plan down on paper. Include:

  • Assigned responsibilities and change approvals
  • Maintenance windows and dependency mapping
  • Communication templates and escalation paths
  • Validation checks and backed-up configurations

Critically, define a rollback procedure before the change starts—not during it. NIST configuration-management guidance recommends testing changes before operational release and retaining the ability to restore a previous baseline if something goes wrong.

Test Thoroughly, Then Test Again

Before and during deployment, verify the full path users and systems actually take:

  • Connectivity, routing, and failover
  • Firewall rules, segmentation, and authentication
  • Wireless coverage and voice or business applications
  • Cloud access and performance under expected load

Retest after cutover so issues surface in the window—not the next business day.

Manage Risk With a Register

Capture likely failure points in a living risk register. Common entries include:

  • Equipment delays and incompatible firmware
  • Overlooked dependencies and licensing gaps
  • Incorrect firewall rules
  • Provider coordination failures

Give each risk an owner, likelihood, impact, mitigation, and contingency. Require an explicit go/no-go checklist before any production change proceeds.

For multi-location rollouts, start with a pilot site or representative workload. Standardize configurations, then sequence remaining sites by risk and business importance.

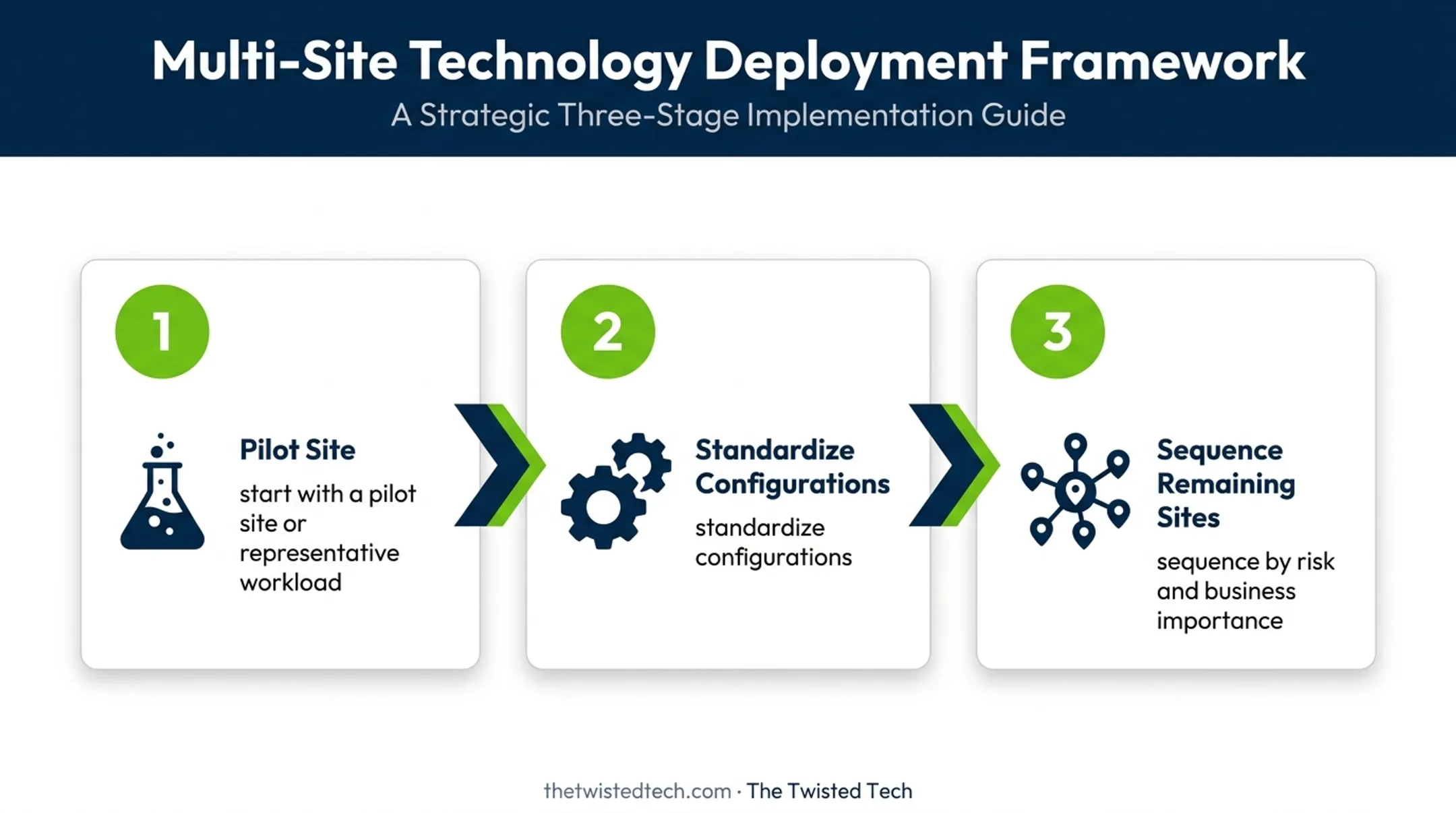

Three-stage multi-location network rollout sequence from pilot to expansion

When the project wraps, keep ownership clear. Executives, IT, employees, facilities, and external providers need updated diagrams, training, and a defined support handoff.

Post-Upgrade Validation and Ongoing Optimization

The upgrade isn't finished at cutover. Compare post-upgrade performance against your original baseline and objectives:

  • Availability and uptime
  • Latency, throughput, and packet loss
  • Application experience and wireless coverage
  • Failover behavior under test conditions
  • Security events and support ticket volume
  • User and stakeholder feedback

Build in a stabilization period with heightened monitoring, quick issue triage, configuration tuning, and updated documentation. How long that period lasts should reflect the project's risk and complexity, not a generic default.

From there, the work shifts to ongoing lifecycle management:

  • Warranties and end-of-support dates
  • License renewals
  • Capacity trends
  • Configuration drift

Growth planning belongs here too. Prioritizing budgets and setting reserves ahead of the next expansion keeps future projects from becoming reactive scrambles.

Skip this step and organizations end up running unsupported equipment—and wondering why the network can't keep up.

Frequently Asked Questions

What does "Spectrum network upgrade" mean?

The phrase can refer to an upgrade of Spectrum's own network, a change to your business internet service, or new equipment. Confirm the exact scope, fees, contract changes, and outage expectations directly with Spectrum before assuming it means a full infrastructure overhaul.

What are the first signs that a business needs a network infrastructure upgrade?

Recurring performance problems, outages, unsupported equipment, security gaps, and limited network visibility are early indicators. Business growth or new locations can also create the need even without a visible failure.

Should a company replace all its network equipment at once?

Phased or targeted upgrades are usually preferable since they limit risk and disruption. A full replacement makes sense when equipment is broadly unsupported, incompatible, insecure, or too costly to keep maintaining.

How long does a network infrastructure upgrade take?

Timing depends on environment size, number of locations, provider dependencies, and testing requirements. Build a phased schedule around your specific scope rather than expecting a universal timeframe.

How can a business reduce downtime during a network upgrade?

Redundancy, pilot testing, staged cutovers, verified backups, and rollback procedures all reduce risk. Pair those controls with clear stakeholder communication and provider coordination.

What should be included in a network upgrade budget?

Beyond hardware, budget for licensing, circuits, implementation, engineering, support, monitoring, training, migration, downtime risk, and future capacity. Hardware is usually only a fraction of the full project cost.
