Introduction: Why IT Contract Management Matters in 2026
Picture this: a SaaS subscription auto-renews for another 12 months because nobody flagged the notice deadline. The team that used it left six months ago. Finance is now paying full price for a tool three people touch.
This happens more than most organizations admit. 36% of SaaS licenses sit unused on average, measured against recommended utilization levels. That figure comes from Zylo's 2026 SaaS Management Index, based on more than 40 million licenses and $75 billion in managed spend.
IT contract management ties signed technology agreements to uptime, data security, vendor accountability, and spending decisions. This guide walks through the full contract lifecycle, the risks that catch organizations off guard, and how to choose the right process and tools for 2026.
Key Takeaways
- IT contract management spans negotiation, execution, tracking, renewal, and termination, not just storage
- Renewal dates, license entitlements, SLAs, and exit terms need tracking before deadlines hit
- Contract data belongs to IT, procurement, legal, finance, and security together, not one inbox
- Software improves visibility, but clear ownership and human review still drive outcomes
IT Contract Management: Definition, Scope, and Ownership
IT contract management is the coordinated handling of technology-related agreements from intake and negotiation through execution, performance monitoring, renewal, and termination.
It differs from general contract management in one important way: it ties legal commitments to technical realities. A software agreement isn't just legal language. It's user counts, licensing rights, uptime guarantees, integration dependencies, data handling rules, and support response times, all wrapped into one document.
IT contract management typically covers:
- SaaS and software licenses
- Cloud services and infrastructure
- Telecommunications and connectivity
- Hardware and maintenance agreements
- Managed services and cybersecurity contracts
- Consulting, development, and outsourcing agreements
- Data processing agreements
Who's Actually Responsible
No single department can manage this alone. Responsibilities generally break down like this:
| Team | Primary Responsibility |
|---|---|
| IT | Validates technical fit and service requirements |
| Procurement | Manages sourcing and commercial process |
| Legal | Reviews contract language and liability |
| Security | Evaluates controls and data risk |
| Finance | Validates spend against budget |
| Business owners | Confirm outcomes and actual usage |
Here's the underlying problem: 48% of organizations report no clarity over who's accountable for contract quality and integrity, according to WorldCC's Benchmark Report 2025. That figure is cross-industry, not IT-specific, but it points to a familiar pattern. When nobody owns a contract, nobody watches the renewal date either.
A mature process delivers fewer surprise renewals, clearer visibility into technology spend, stronger vendor accountability, and better audit readiness. It also strengthens your negotiating position, because decisions rest on documented requirements instead of guesswork made under deadline pressure.
Key IT Contract Types and Terms to Understand
How the Core Documents Work Together
Most technology engagements aren't governed by a single contract. They're built from layered documents that work together.

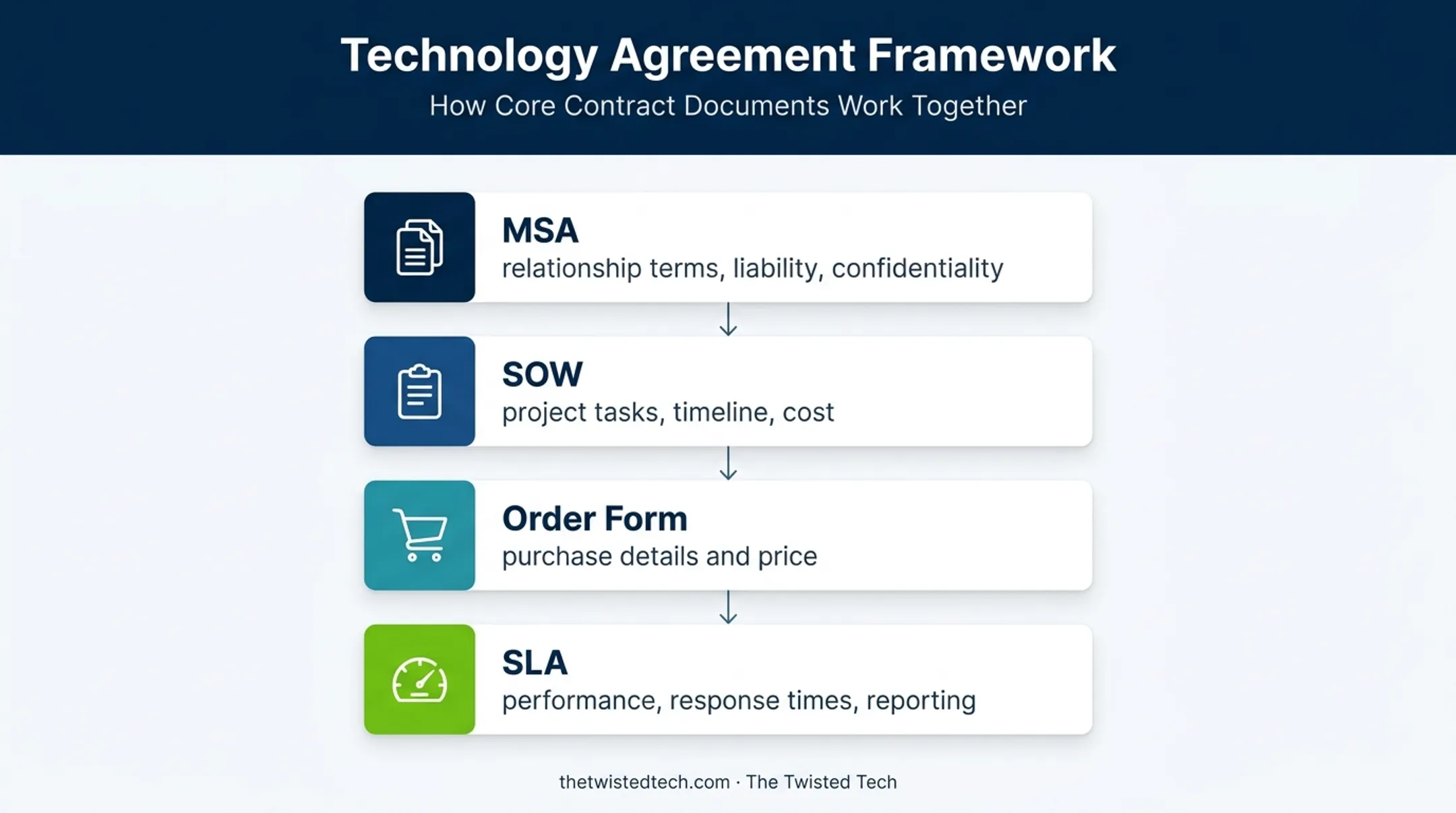

Take a managed services engagement as an example. The master services agreement (MSA) sets the overall relationship terms, liability caps, confidentiality, and general payment structure.
Thomson Reuters legal guidance describes an MSA as the broader agreement governing the relationship. A project-specific statement of work (SOW) narrows the scope to a particular project's tasks, timeline, and cost.
Add an order form that specifies exactly what's being purchased and at what price. Then layer in a service-level agreement (SLA), defined by NIST as a provider commitment addressing responsibilities, expected performance or response times, and reporting and resolution.
Together: the MSA sets the rules, the SOW defines the project, the order form locks in pricing, and the SLA defines performance expectations.

SaaS and Software License Terms
Software agreements use this same document stack. Before signing, review these carefully:
- Subscription period and renewal terms - auto-renewal windows and notice deadlines
- User or usage limits - what triggers overage or true-up charges
- True-up rules - how mid-term user or device growth is reconciled (Microsoft enterprise agreements typically true up annually)
- Audit rights - a vendor's ability to inspect your usage records, including notice, scope, and confidentiality limits
- Data portability - your ability to extract data in a usable, non-proprietary format if you leave
- Termination assistance - what help, if any, you get transitioning away
Cloud, Managed Services, and Cybersecurity Terms
These agreements carry higher stakes because they often touch sensitive data and business continuity directly. Review:
- Availability commitments and support tiers - uptime targets and how support is prioritized
- Incident notification timelines - how quickly the provider must alert you
- Data location and subcontractor use - where data resides and who else may access it
- Backup, recovery, and business continuity provisions - restore objectives and failover expectations
- Security attestations - SOC 2, ISO 27001, and similar control reports
- Transition assistance and service credits - exit support and remedies for missed SLAs
Have qualified legal and security professionals assess how these terms apply to your specific data, industry, and jurisdiction. A SOC 2 report or ISO 27001 certification confirms a vendor has controls in place; it doesn't define your contract's actual breach-notification deadline or data-handling promises.
The IT Contract Lifecycle: From Request to Renewal

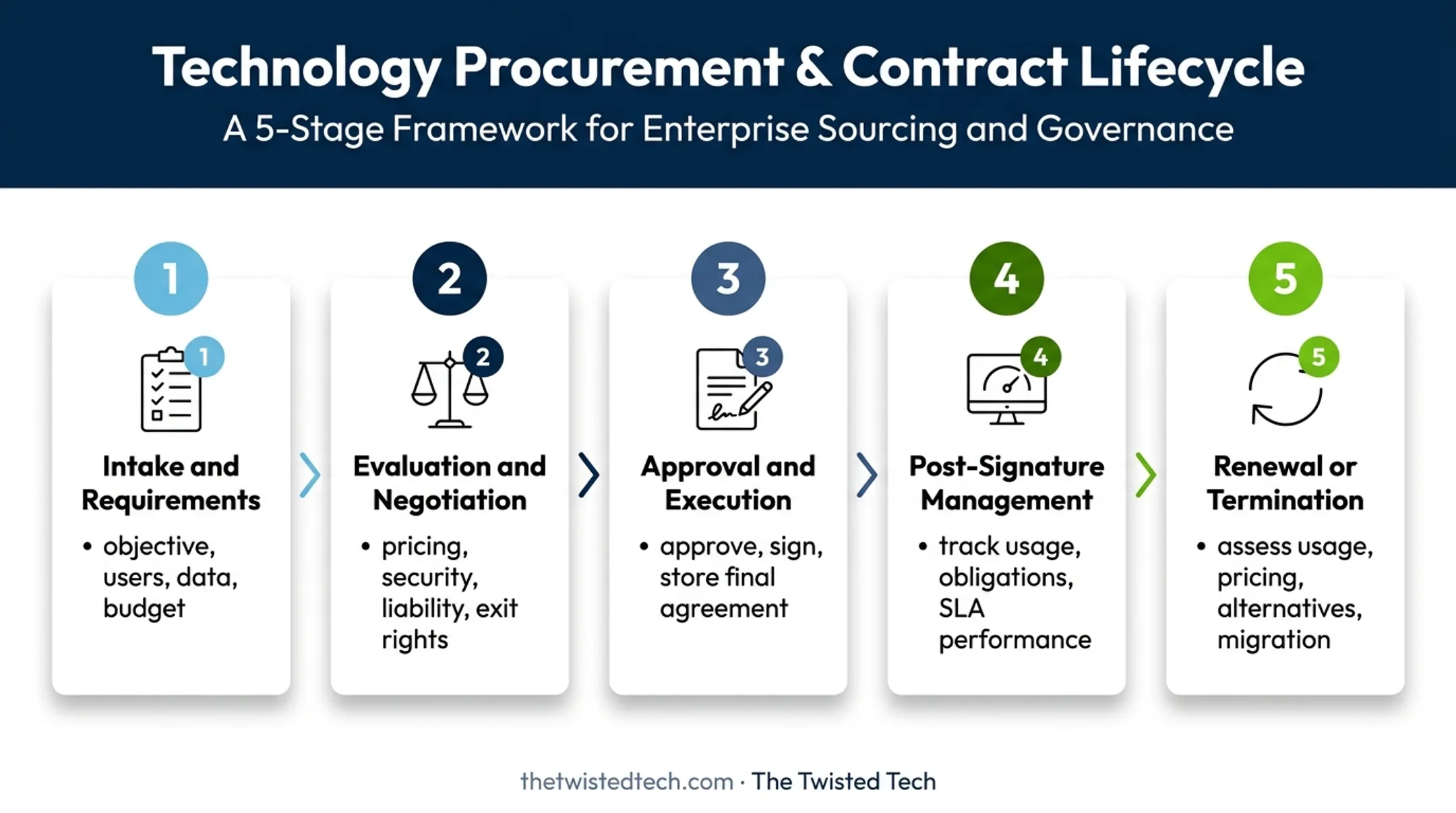

Managing IT contracts well means treating the process as ongoing, not a one-time signing event.
Intake and requirements. Define the business objective, user count, locations, integrations, data involved, required service levels, budget, and timeline before requesting proposals. Skipping this step is why so many contracts get renegotiated within a year.
Evaluation, drafting, and negotiation. Compare vendors against documented requirements, not just price sheets. Review pricing models, escalation limits, implementation assumptions, liability terms, security posture, IP ownership, and exit rights. Flag non-standard clauses for legal review before signing.
Approval and execution. Set clear approval thresholds so a small purchase doesn't require the same sign-off as an enterprise agreement. Route the contract to the right stakeholders and confirm you're signing the final negotiated version. Verify authorized signatories, then store the executed agreement with related orders, SOWs, and amendments.
Post-signature management. This is where most organizations lose track. Convert contractual obligations into assigned actions. Track license entitlements against actual usage. Monitor SLA performance. Schedule periodic security reviews and document any changes as they happen.
Renewal, renegotiation, or termination. Start this review well before the notice deadline, not after it passes. Assess actual usage, vendor performance, pricing changes, available alternatives, migration effort, and data-return requirements before deciding whether to renew, renegotiate, replace, or exit.

A major renewal review typically covers:
- Current technology and business requirements
- Market benchmarks against available alternatives
- Pricing and terms compared across providers
- The path that fits: renegotiate, renew, or replace
That sequence matters more than which specific tool tracks it. Staying involved through implementation and optimization, not just the signature, is what catches problems before they become emergencies.
Common IT Contract Management Risks and Challenges
IT contracts create risk when records, spend, and security obligations fall out of sync. These patterns show up most often.
Fragmented Records and Unclear Ownership
When agreements live across email threads, shared drives, procurement tools, and vendor portals, basic questions get hard to answer: What's the current version? Who owns this? What are we obligated to do? When does it expire?
That fragmentation is why unclear ownership and accountability show up so often in IT contract management.
Financial and Operational Leakage
Money leaks through:
- Unused or duplicate licenses still on the books
- Auto-renewals nobody reviewed before the deadline
- Untracked price escalators buried in multi-year terms
- Missed service credits for SLA breaches
- Integrations that stopped working after a platform update
- Contracts that no longer match how the organization operates
Flexera's 2026 State of ITAM Report—a worldwide survey of 512 IT asset management professionals—found reported SaaS waste up 10 percentage points year over year. That's a shift in survey responses, not a claim that 10% of spend is wasted, but the direction is worth noting.
Security, Privacy, and Resilience Exposure
Contract terms need to match technical reality. Review:
- Data-processing terms and where data actually resides
- Breach notification timelines and subcontractor controls
- Access management and audit rights
- Business continuity and disaster recovery provisions
- Exit planning and data-return obligations

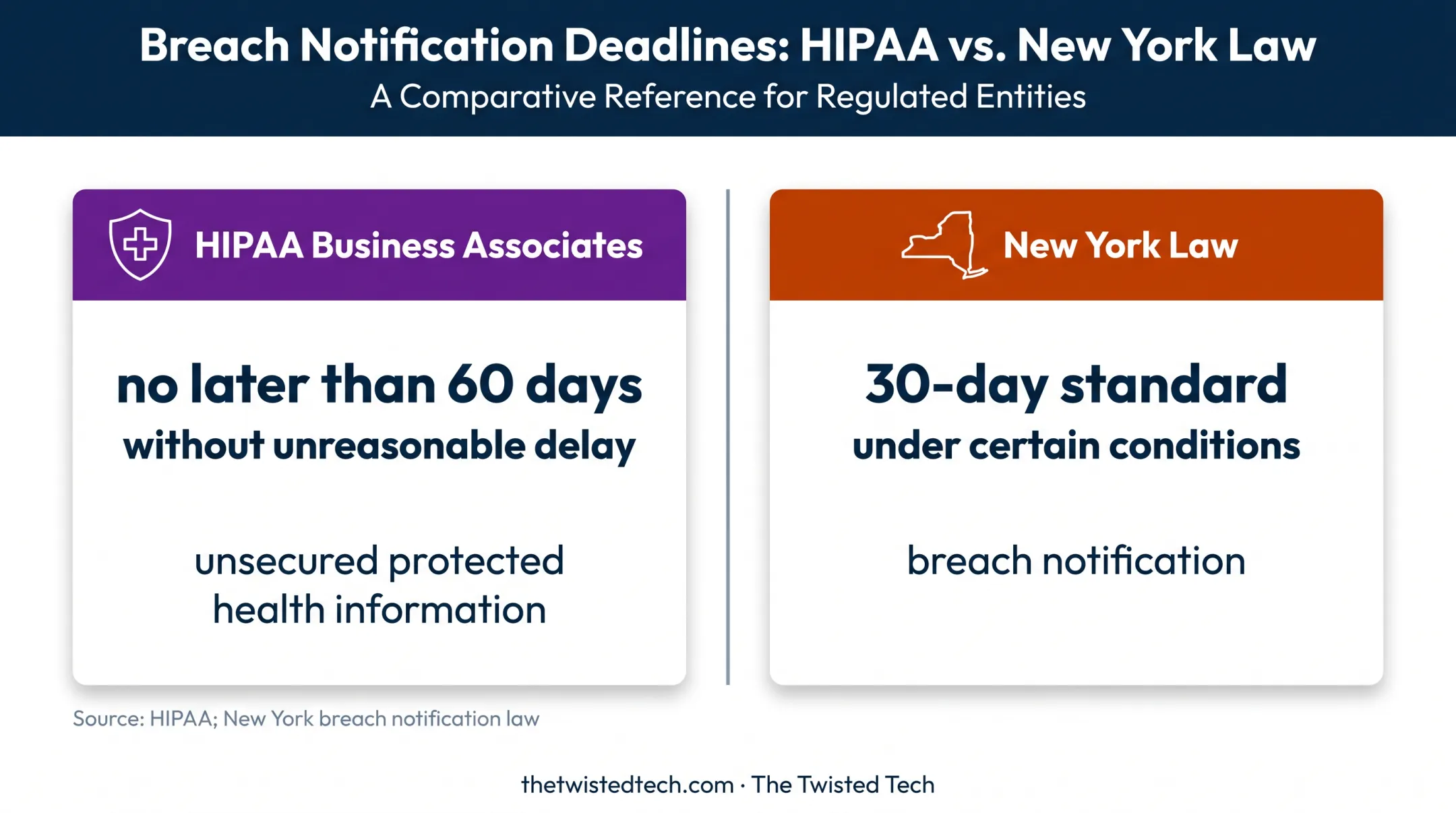

Notification requirements vary widely by sector and jurisdiction. HIPAA business associates must notify covered entities of a breach involving unsecured protected health information without unreasonable delay and no later than 60 days. New York's breach notification law sets a separate 30-day standard under certain conditions.

Verify which federal, state, industry, or contractual requirements actually apply to your organization rather than assuming one rule covers everything.
Best Practices for Managing IT Contracts in 2026
Build a Single Source of Truth
Every contract needs consistent metadata in one system:
- Owner
- Key dates and renewal notice period
- Spend, vendor, and service category
- Data classification and risk level
When this information lives in one place, "when does this renew" stops requiring a scavenger hunt.
Standardize Intake and Approval
Build workflows with clear decision rights:
- Approved templates and fallback negotiating positions
- Escalation paths for non-standard terms
- Documented exceptions when you deviate from standard process
- A clear line between low-risk routine purchases and high-risk agreements needing legal, security, or executive review
Start Renewal Reviews Early
Don't wait for the notice window. Review these factors well ahead of the deadline:
- Usage and license fit
- Performance issues and unresolved complaints
- Pricing changes and competitive alternatives
- Roadmap fit and implementation dependencies
Reassessing before you're forced to decide under time pressure changes your entire negotiating position.
Measure What Matters
Track practical indicators instead of vanity metrics:
- Contract cycle time
- Renewal decisions completed before notice deadlines
- Percentage of contracts with assigned owners and key dates
- License utilization rates
- SLA performance against commitments
- Open obligations and unresolved risk items
59% of surveyed IT professionals reported tracking SaaS usage, and 56% reported actively rightsizing contracts and subscriptions, according to Flexera's 2025 State of ITAM Report, a survey of 506 global IT professionals. These are reported practices, not universal targets. Build your own baseline before setting goals.
Apply AI Responsibly
AI tools help with document classification, metadata extraction, clause comparison, obligation discovery, and alerts. But generative AI can produce confident, inaccurate output. Require these controls:
- Human validation before decisions
- Access controls and auditability
- Secure data handling
- A defined correction process when AI is wrong
Choosing Software: CLM, ERP, or a Lighter Approach
Match the Tool to the Job
These platforms solve different problems:
| Option | Best For |
|---|---|
| Spreadsheets or shared repository | Basic contract inventory for small portfolios |
| CLM (contract lifecycle management) | Intake, workflows, repositories, obligation tracking, renewals, contract intelligence |
| ERP or procurement suite | Financial, purchasing, supplier, and transaction workflows |
Capabilities vary widely by product, so don't assume every CLM or ERP does the same thing. Source-to-pay suites often include CLM functionality too, which means these categories overlap more than they compete.
Selection Checklist
Confirm the platform covers the basics—and that the buy still makes sense:
- Searchable repository with OCR
- Metadata fields and relationship mapping between documents
- Renewal alerts and approval workflows
- Version control and e-signature
- Permission controls, audit history, and security fit for your data
- Obligation tracking and reporting
- Integrations with existing systems
- Realistic implementation effort and total cost of ownership
Evaluate Beyond the Demo
A polished demo doesn't tell you how a tool handles your actual contracts. Instead:
- Document your requirements before you start looking
- Test the tool against a real, messy contract from your own portfolio
- Confirm integration and data migration assumptions upfront
- Ask specifically how AI outputs get validated
- Assess implementation support and expected adoption timeline
- Define what success looks like before signing anything
For organizations without the internal bandwidth to run this comparison alone, independent, vendor-neutral guidance can help. The Twisted Tech works with growing organizations to define requirements, compare providers, negotiate terms, coordinate implementation, and prepare for renewal, without pushing a specific platform or provider.
Frequently Asked Questions
What is IT contract management?
IT contract management is the discipline of handling technology agreements from intake and negotiation through execution, obligation tracking, performance management, renewal, and termination. It ties legal commitments to technical details like licensing, uptime, and data handling.
What is the difference between CLM and ERP for IT contract management?
CLM tools generally manage contract-specific lifecycle stages, language, workflows, obligations, and renewal data. ERP systems generally manage financial, purchasing, supplier, and transaction data. Many organizations integrate both rather than choosing one exclusively.
What is the best contract management software for IT?
The best choice depends on your organization's size, contract complexity, workflows, integrations, security requirements, and budget. Compare tools against your own validated requirements and real contract scenarios rather than relying on a generic ranking.
